Garage Conversion ADU Cost in California: Full 2026 Line-Item Breakdown

Updated:
Edit page

In this series

Every build below uses the same six-phase ledger, so you can compare any two directly.

New construction

Compare any two builds side by side →

Published: 4 Sep 2026 · Last verified: 5 Sep 2026 · Next review: Dec 2026 Cost figures are re-checked against permit records quarterly. Changes are logged in Corrections.

A garage conversion is not a discounted detached ADU. It is a different project with a different phase mix: you reuse a shell, then spend hard on insulation, egress, fire separation, wet rooms, and — often — replacing the parking you just eliminated.

We modeled a typical two-car garage conversion in Los Angeles County: roughly 450 square feet of living area, mid-grade finishes, existing slab retained where sound, flat lot. The total came to $190,000, or about $422 per square foot of living area.

That is less cash than a new 400 sq ft detached ADU at $215,000, and far less than an 800 sq ft detached at $320,000. It is not automatically the better deal — parking replacement, HOA rules, and local ordinances can erase the advantage or stop the project entirely.

The short answer

2-car garage conversion · ~450 sq ft living · LA County · 2026Amount
Total conversion cost$190,000
Cost per sq ft of living area~$422
Compared to 400 sq ft new detached$215,000 / $537 per sq ft
Compared to 800 sq ft new detached$320,000 / $400 per sq ft
Phases that usually shrinkSite + foundation, framing
Phases that often growEnvelope, landscaping / parking replacement

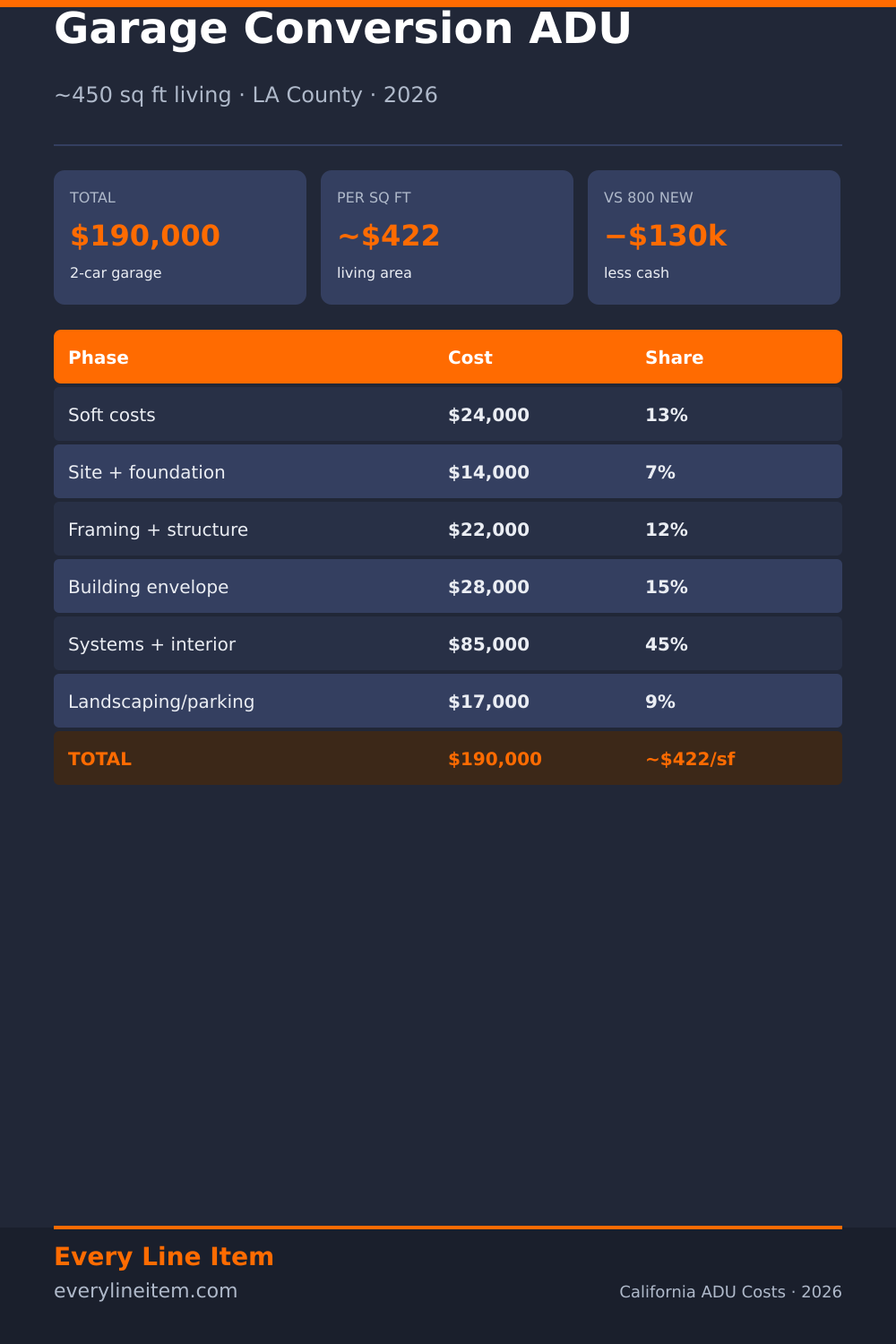

Garage conversion ADU cost breakdown — $190,000

Pin this breakdown: right-click / long-press the image, or use the Pinterest share button.

The full line-item breakdown

Same six phases as the rest of this series, so you can compare rows directly to the detached models.

PhaseCostSharevs new detached
Soft costs (design, permits, plan check)$24,00013%Slightly lower than 400 detached
Site work + foundation$14,0007%Shrinks — reuse slab, limited excavation
Framing + structure$22,00012%Shrinks — partitions, openings, headers
Building envelope$28,00015%Grows share — insulation, windows, fire, weather
Systems + interior$85,00045%Still the largest line
Landscaping & hardscape (incl. parking replacement)$17,0009%Grows — replace lost stalls
Total$190,000~$422 / sq ft

Notice the shape: foundation and framing are no longer a combined 24–27% the way they are on new detached builds. Envelope and parking hardscape pick up share. Systems and interior remain the money — one kitchen, one bathroom, MEP rough-in, and finishes.

What you are actually buying

Soft costs — $24,000

Still real. You need architectural drawings for the conversion, structural engineering for new openings and any loft or roof work, Title 24 energy documentation, plan check, and building permits. Fees are often lower than a full new detached valuation, but not free. See the soft costs deep dive for line-item ranges.

Site work + foundation — $14,000

This is where conversions save. You are not pouring a new stem wall and slab for a whole building. Typical work: moisture barrier or slab coating, limited saw-cutting for plumbing trenches, leveling or patching, and waterproofing at the garage door opening once it becomes a wall or glazed facade. If the existing slab is cracked, heaving, or below flood requirements, this line climbs fast — sometimes enough to erase the conversion advantage.

Framing + structure — $22,000

Interior partitions for bath and kitchen, headers over new windows and the former garage door opening, possible ceiling or roof framing if you need height or a loft, and shear or hold-down work if you punch new openings in braced walls. Cheaper than framing an entire 400–800 sq ft shell. Not a paint-and-carpet job.

Building envelope — $28,000

This phase grows relative to what homeowners expect. Uninsulated garage walls and roofs become conditioned dwelling envelope. That means insulation to current code, air sealing, new or enlarged windows for light and egress, exterior finishes where the garage door was, and fire-resistance detailing between the ADU and the main dwelling when attached or close. Skip this phase and you get a cold, illegal, or unpermitted unit.

Systems + interior — $85,000

Still about 45% of the budget. Full kitchen, full bath, electrical panel or subpanel work, plumbing supply and waste from the main house or new lateral, heat pump or equivalent, drywall, flooring, paint, fixtures, appliances. Absolute dollars sit below the 400 detached model’s $102,000 because you are not building as much new shell around the wet rooms — but the wet rooms themselves do not get cheaper.

Landscaping & hardscape — $17,000

On many lots this is where conversions hurt. California ADU rules generally protect the right to convert, but replacing required parking — or satisfying an HOA that still thinks in pre-state-law terms — can mean a new driveway apron, uncovered stalls, or alley access work. Budget it. If parking replacement is impossible on your lot, the project may be dead regardless of the construction number.

Garage conversion vs 800 detached

Garage conversion (~450 sf)800 sq ft new detached
Total$190,000$320,000
Per sq ft~$422$400
Soft costs$24,000$32,000
Site + foundation$14,000$38,000
Framing$22,000$48,000
Envelope$28,000$42,000
Systems + interior$85,000$147,000
Landscaping / parking$17,000$13,000

You spend $130,000 less than the 800 detached model and get roughly half the living area. Per-foot efficiency is similar to the large detached unit and better than the 400 detached at $537 — if the existing garage is structurally sound and parking can be replaced without heroics.

When the conversion wins

When the conversion loses — or dies

Parking replacement. If local practice or an HOA still demands replacement stalls you cannot fit, stop before you pay for drawings.

HOA and CC&Rs. State ADU law has narrowed what associations can ban, but architectural review, rental restrictions, and parking covenants still create delay and cost. Get written clarity early.

Fire and egress. Bedrooms need compliant egress. Attached configurations need fire separation. These are not optional upgrades.

Bad slab or low ceiling. Replacing a slab or raising a roof can push a “cheap conversion” past new-build studio pricing.

Utility capacity. Panel upgrades and sewer tie-ins still apply. Distance and upsizing do not care that the walls already exist.

Local rules. Always verify with the current municipal ADU ordinance and the California HCD ADU Handbook. Do not rely on a neighbor’s 2019 conversion story.

What this number does not include

Not included in $190,000Typical impact
Construction loan interestCarried for the conversion schedule
Property tax on new / converted valueAdded assessment on the ADU work
HOA architectural fees or private reviewsHighly variable; can be project-killing
Contingency10% to 15%
Full garage demolition + new detached elsewhereSeparate project

A 12% contingency here is about $22,800. If parking replacement bids come in ugly, that contingency gets used fast.


Put your own quote in these six rows

We made a blank version of the six-phase ledger. Drop your contractor’s numbers into it and see which line doesn’t match ours.

Download the worksheet — CSV (import to Google Sheets), no email required

Want the regional benchmark ranges for each phase, updated quarterly?

Get the benchmark sheet →

Methodology and sources

Every figure on this page is a modeled median, not a quote. Here is exactly how it was built, so you can check it or reproduce it yourself.

InputSource
Statewide ADU rules, size limits, and fee exemptionsCalifornia HCD ADU Handbook
2026 changes to State ADU LawHCD Addendum, December 2025
Declared construction valuations, unincorporated LA CountyEPIC-LA permit portal
Declared construction valuations, City of Los AngelesLADBS Permit & Inspection Report
Permit record datasetLA County Open Data — EPIC-LA Permit Finder
Phase-level cost shares for residential constructionNAHB Cost of Construction Survey
Per-square-foot construction price benchmarksNAHB Survey of Construction
Regulatory share of finished build costNAHB regulatory cost study, June 2026
Zoning and parcel constraintsZIMAS

Check this number against your own address

Most California jurisdictions publish permit records online, including the declared construction valuation for each project. That declared valuation is the closest thing to a real local baseline you can get without paying anyone.

  1. Open EPIC-LA for unincorporated LA County, or the LADBS Permit & Inspection Report for addresses inside the City of Los Angeles.
  2. Search recent ADU permits within about a mile of your address.
  3. Compare the declared valuation to the phase totals on this page.

Declared valuations run below contract price — treat them as a floor, not a total. Full detail on Methodology.

If your local numbers diverge meaningfully from ours, we want to know. See Corrections.

Our position

We don’t build ADUs. We don’t sell plans. We don’t sell your information to contractors. No figure on this site has been paid for or reviewed by anyone whose costs we publish. More on About.

Figures are Los Angeles County, 2026, stated as medians of contractor ranges. Costs vary by jurisdiction, site access, and finish level. This is construction cost information — not a quote, and not legal, engineering, or financial advice. Confirm requirements with your local building department and a licensed California contractor.

Frequently asked questions

How much does a garage conversion ADU cost in California?

This model lands at $190,000 for a typical two-car garage conversion (~450 sq ft living) in Los Angeles County with mid-grade finishes. Sound structures with easy utilities can come in lower; slab replacement, roof raises, and parking work push higher.

Is a garage conversion cheaper than building new?

Usually cheaper in absolute dollars than a new detached unit of similar living area — this model is $25,000 below our 400 sq ft detached and $130,000 below our 800. Per-square-foot can still look high if living area is small, and parking/HOA issues can wipe out the savings.

Do I still need permits for a garage conversion?

Yes. A conversion to dwelling space requires permits, energy compliance, and inspections. Unpermitted conversions create rental and resale problems the same way unpermitted new ADUs do.

What about parking?

Budget for replacement parking hardscape in the landscaping phase, and verify local and HOA rules before design. Parking is one of the most common reasons garage conversions stall.

How long does a garage conversion take?

Often shorter in pure construction than a new detached build — commonly on the order of a few months of construction once permits are in hand — but permitting and HOA review can still dominate the calendar.

Should I convert or build detached?

Convert when the garage is sound, parking is solvable, and you want lower absolute cost. Build detached when you need more space, the garage is poor quality, or conversion rules/parking make the retrofit a dead end. Compare against the 800 and 400 detached models using the same six phases.


Edit page
Share this post:

Previous Post
Modular vs Site-Built ADU Cost in California: 2026 Line-Item Comparison
Next Post
Coastal vs Inland ADU Cost in Southern California: Same Plan, Different Bill (2026)
